Ending a federal contract involves more than stopping work or paying the last invoice. Contract closeout and termination for convenience serve different purposes, and each carries administrative, financial, and legal requirements. Understanding the distinction helps contractors manage their obligations and prepare for the recovery available under their contracts.
Contract closeout completes the administrative process after physical completion and resolution of the applicable outstanding matters. A termination for convenience, by contrast, ends all or part of contract performance on the effective date identified in the government's notice. The settlement process may continue after that date; an approved settlement is not a prerequisite to the termination taking effect. A terminated contract still requires closeout once its termination actions are complete. See FAR 49.102 and FAR 4.804-1.
With rights and liabilities at stake, the settlement proposal plays a significant role in termination. Closeout can also present challenges when unresolved costs, property issues, or documentation delay completion. This article addresses both processes and what contractors should do to prepare. The demand is straightforward: know your contract, know the rules that apply, and be proactive.

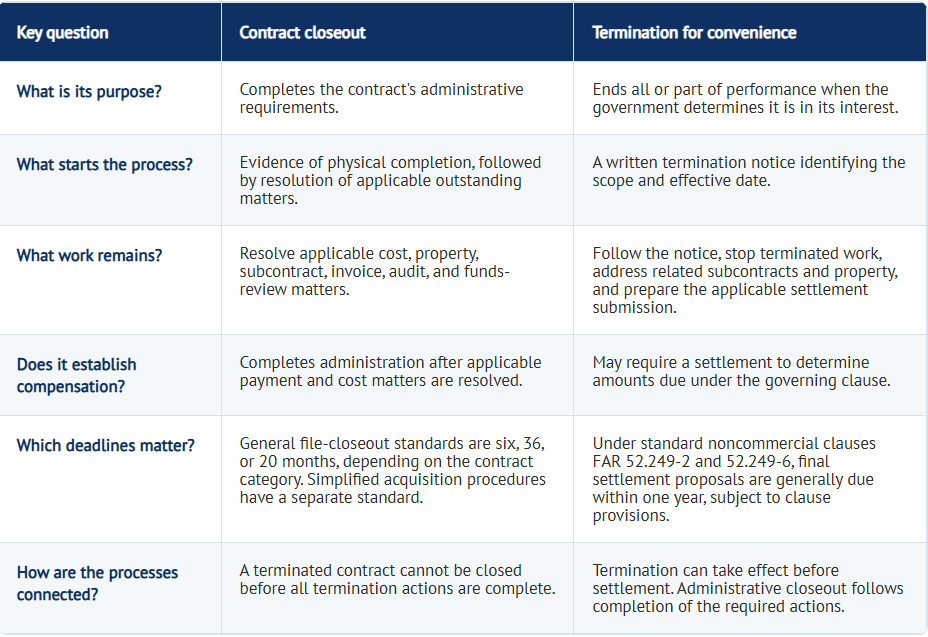

How Do Contract Closeout and Termination for Convenience Compare?
On smaller screens, scroll horizontally to view the full table.
The timeframes above serve different purposes and begin at different milestones. See the detailed sections below for categories, timing triggers, exceptions, and the contract clauses that apply.
What Should Contractors Know About Ending a Federal Contract?
One of the first questions parties should ask about an anticipated contract is how the agreement can end and what its terms and conditions require. The Federal Acquisition Regulation (FAR), codified in Title 48 of the Code of Federal Regulations, provides the principal regulatory framework for federal procurement contracts. Agency supplements, authorized deviations, and the clauses incorporated into the contract also matter. See FAR 1.104.
How Does the RFO Affect Contract Closeout and Termination Guidance?
The Revolutionary FAR Overhaul (RFO) makes it especially important to check applicable agency deviations and the contract's incorporated clauses and modifications. For example, the RFO model text places closeout procedures in sections 4.308-1 and 4.308-2, while the codified FAR references used below remain in Subpart 4.8. The RFO Part 42 model places quick-closeout procedures in section 42.507. Model text and agency implementation should be read together.
Legal and administrative terms appear throughout the contracting process: closeout, termination for default, termination for cause, termination for convenience, and breach of contract. These terms describe different actions and consequences. Contractors should identify the government's actual action and the clause authorizing it before deciding how to respond.
On my first day in contracts, the professor pointed out that most everyone in the class had a connection with a contract: an apartment lease, a car loan with a bank, a student loan, or a credit card with terms and conditions in an exceedingly small font. The lecturer continued by explaining that being a party to a contract, implementing the document, enforcing those terms and conditions, and ending the agreement involve administrative, financial, and legal steps. Contracting is a lengthy process from beginning to end.
The history of contract law is long and complex. Contracts have played a major role in society for centuries, and their development reflects changing commercial practices, public needs, and legal protections. Federal procurement adds a detailed framework governing how agencies buy goods and services, administer performance, and bring agreements to a conclusion.
Centuries have been spent identifying the concept of need and the process of meeting that need. Historically, the development of contracts is based on centuries of research by scholars, academics, lawyers, politicians, individuals and groups identifying and developing the concepts and the terms and conditions necessary for the development of these agreements.
Government priorities, program needs, and funding decisions can change during contract performance. Those changes may lead an agency to consider termination for convenience. The decision to terminate does not, by itself, establish the amount of savings or eliminate the government's obligations to the contractor.
For the government, the starting point is to determine whether ending all or part of performance is in its interest under the applicable termination clause. For the contractor, the starting point is the contract and the written notice, including the scope and effective date of the termination.
Once notified, the starting point for the contractor is to examine the administrative, financial, legal, and programmatic requirements. With emphasis on stopping work, changes that could be partial or complete, and any possible adjustments, the contractor prepares the settlement proposal.
It is important to understand that a contract is a set of promises based on a need and a plan to meet that need. For the party buying goods or services, another party becomes the source for meeting the requirement. The resulting document identifies performance obligations, payment terms, and the rights and responsibilities of both parties.
Do the Same Rules Apply to Procurement Contracts and Grants?
The U.S. government has broad needs, ranging from housekeeping and medical services to engineering, scientific research, information technology, and specialized equipment. Procurement contracts support those needs. Grants and cooperative agreements are financial assistance instruments governed by a different framework; their termination and closeout rules should not be treated as interchangeable with FAR procurement procedures. This article focuses on procurement contracts. See 2 CFR 200.340 for grant termination provisions.
A procurement contract identifies what performance requires, what must be delivered, and how payment will be made. The acquisition method may involve a request for proposals, an invitation for bids, or other authorized procedures. The government evaluates offers and makes an award under the applicable process; negotiations, when used, occur as part of that process. The executed agreement provides the framework for future actions by both parties.
Terminology matters because a contract's type and clauses help determine which ending procedures apply. The commercial acquisition framework, for example, differs from the procedures governing many noncommercial contracts. A contractor should begin with the agreement actually awarded rather than assume that every federal contract follows the same settlement rules.
Can Deobligated Funds Be Used for New Projects?
Funding also matters. Deobligation reduces or cancels a previously recorded obligation, but it does not automatically make money available for new projects. Whether deobligated funds can support a new obligation depends on the appropriation's purpose, period of availability, and other applicable restrictions. Expired fixed-period appropriations generally remain available to adjust and liquidate valid prior obligations, not to incur new ones. See GAO fiscal guidance on deobligation.
How Does Federal Contract Closeout Work?
When the work is finished and the final invoice has been paid, it can be tempting to move on. Administrative closeout still matters. Outstanding rates, property records, subcontract settlements, or other requirements can leave the contract file open even after performance has ended.
Closeout is an administrative set of steps and substeps. The parties must work together to meet the applicable requirements, complete the record, and identify excess funds. A contract is generally physically complete when required deliveries or services have been accepted and its options have expired, or when the government has issued a notice of complete contract termination. Physical completion and administrative closeout are separate milestones. See FAR 4.804-4.
The practical challenge is to identify what remains unresolved and who is responsible for completing it. Contractors can support closeout by maintaining accurate records throughout performance and responding promptly to requests for final documentation. Waiting until the final invoice to address open issues can make the process more difficult.
What Are the Federal Contract Closeout Timeframes?
Under FAR 4.804-1, firm-fixed-price contract files other than those using simplified acquisition procedures should generally close within six months after the contracting officer receives evidence of physical completion. Files requiring settlement of indirect cost rates should close within 36 months of the month that evidence is received; other contract files should close within 20 months of that month. Simplified acquisition files generally close upon evidence of receipt of property and final payment, unless agency regulations specify otherwise. These are closeout time standards, not settlement-proposal deadlines.
The closeout procedures in FAR 4.804-5 address applicable matters such as property clearance, subcontract settlements, indirect cost rates, audits, final invoices, the termination docket, and review of contract funds. Requirements depend on the contract. DD Form 1594 may be used in the DoD process, but it should not be described as a universal checklist for every federal contract. Under FAR 4.804-1, a file must not be closed while the contract is in litigation or under appeal, or before all termination actions are complete.
How Do Indirect Cost Rates and Quick Closeout Affect the Process?
Indirect cost rates can be an important part of closeout for contracts that require them. Under FAR 52.216-7, a contractor generally must submit an adequate final indirect cost rate proposal to the contracting officer or cognizant agency official and auditor within six months after the end of its fiscal year, subject to authorized extensions. That annual submission requirement is separate from the 36-month closeout standard.
An audit or other review can support the establishment of final indirect cost rates, but the auditor and contracting officer do not always perform the same role. FAR 42.705-1 addresses contracting officer determination procedures; the responsible official and process depend on the contractor and contract. DCAA and DCMA are important participants in many defense contracts, but they are not the sole audit and administration authorities for all federal contracts.
Quick-closeout procedures can allow settlement of direct and indirect costs before final costs and rates are determined. Under FAR 42.708, the general threshold is the lesser of $1 million or 10 percent of the contract, task order, or delivery order amount, with physical completion, a risk assessment, and agreement on a reasonable estimate also required. DFARS 242.708 provides different defense authority: a $2 million threshold in place of the general FAR thresholds, and authority for DCMA administrative contracting officers to negotiate regardless of the dollar value or percentage of unsettled costs. Applicable deviations must also be checked.
At the start of administrative closeout, the contract administration office reviews the funds status and notifies the contracting office of any excess funds it might deobligate. Closeout also includes completing the funds review and deobligating excess funds. The timing of these actions is subject to applicable agency requirements.
Closeout provides a way to finish administrative responsibilities and identify funds no longer needed for a contract. It is not a substitute for termination settlement when performance has been terminated. A terminated contract must complete the applicable termination actions before the file can be closed.
To strengthen your team's understanding of contract administration and closeout, explore the FPS course catalog for relevant training options.
How Does Termination for Convenience Work?
New contracts may be awarded while other contracts are being terminated because agencies have different requirements and priorities. For contractors, the practical issue is not whether all new awards are immune from termination. It is whether the business understands the risks, clauses, and potential settlement obligations attached to each agreement.
A contractor bidding on a federal procurement should examine the applicable termination clause. Under standard clauses such as FAR 52.249-2, the government may terminate performance in whole or in part when the contracting officer determines that termination is in the government's interest. A convenience termination does not itself mean that the contractor failed to perform.
Government interest is influenced by executive priorities that may change when the administration changes. Determinations based on need, the need to expand supply chains, infrastructure breakdowns, budgetary priorities, and unseen events like natural disasters, acts of war, pandemics, international disasters; all fall under government decisions on best interest. To acquire what is necessary at the time, the government determines the life cycle of contracts that have been awarded and determines if the best interest of the government requires termination.
Which Clauses Govern Termination and Stop Work?
The governing clause varies with the contract. Noncommercial fixed-price and cost-reimbursement contracts may use clauses such as FAR 52.249-2 and FAR 52.249-6. Commercial product and commercial service contracts generally use FAR 52.212-4, with termination policies in FAR 12.403. Part 49 may provide guidance for commercial terminations only to the extent that it does not conflict with the commercial framework. An omitted clause raises a separate legal question and should not be treated as creating an automatic termination right in every agreement.
Changes clauses, stop-work clauses, and excusable-delay provisions address different circumstances. Under FAR 52.242-15, a stop-work order can be canceled and performance resumed, or the work can subsequently be terminated. The order itself is not necessarily a termination notice. When a convenience termination occurs, contractor compensation is governed by the applicable clause and settlement rules. Anticipated profit on work not performed is not an ordinary convenience-settlement entitlement. See FAR 49.202.
For noncommercial contracts governed by Part 49, FAR 49.102 requires a written notice identifying the termination authority, effective date, extent of termination, and special instructions. The contractor should determine which work must stop and which work, if any, must continue. A partial termination does not necessarily end the entire contract.
FAR 49.104 describes the prime contractor's duties after receiving a termination notice. These generally include stopping the terminated work, ending related subcontracts, protecting property, and addressing subcontractor liabilities. Property transfer and disposition should follow the contract and the contracting officer's directions. The contractor should preserve the records needed to support its settlement proposal.
How Is a Termination Settlement Developed?
The termination contracting officer (TCO) directs required actions, examines the settlement proposal, and negotiates with the prime contractor. If a complete settlement cannot be negotiated, the TCO may settle the unresolved elements by determination. FAR 49.105 does not make an agreed settlement plan a condition for the termination itself to take effect.
FAR 49.105 also provides for a prompt conference to develop a program for settlement. Topics include the extent of termination, continuing work, subcontractor settlements, inventory, accounting practices, proposal format, financing, and a tentative negotiation schedule. Discussing and documenting these matters helps organize the process; it does not require advance agreement on every settlement issue.
For fixed-price settlements addressed by FAR 49.206-2, the inventory basis is generally preferred. It identifies costs allocable to the terminated portion, including materials, appropriate initial and administrative charges, subcontract settlements, and settlement expenses. A total-cost basis is not an unrestricted alternative: it generally requires advance TCO approval when the inventory basis is impracticable or would unduly delay settlement. The provision also specifies situations in which a total-cost basis is required.
The objective under FAR 49.201 is fair compensation for work done and preparations made for the terminated portion, including an appropriate profit allowance. Recovery is not simply the unpaid balance of the contract. Profit limitations and potential loss adjustments require attention under FAR 49.202 and the governing clause. For commercial fixed-price contracts, FAR 12.403 instead addresses payment for the percentage of work performed and demonstrable charges directly resulting from termination; the contractor may use its standard recordkeeping system.
What Are the Deadlines for Appealing a Contracting Officer's Decision?
Settlement negotiations and an appeal are distinct stages. When a dispute requires a contracting officer's final decision under the Contract Disputes Act, FAR 33.211 describes the appeal notice: the contractor generally has 90 days from receipt of that decision to appeal to the appropriate board of contract appeals, or 12 months from receipt to bring an action in the U.S. Court of Federal Claims. These are alternative routes, not a nine-month extension after a board appeal. A proposal, claim, final decision, and appeal each have their own procedural requirements.
After completion of performance or termination, the parties must still address the outstanding administrative matters needed to close the file. Any excess funds identified through that process are subject to the applicable fiscal rules. Their deobligation should not be equated automatically with spendable savings or authority to fund another program.
The FAR, agency acquisition rules, and contract terms provide the framework for closeout and termination for convenience. The next step is preparation: identifying responsibilities early, keeping records current, and understanding which procedures apply to the specific agreement.
How Can Contractors Prepare for Termination for Convenience?
Closeout has defined steps, but it is not always simple. Indirect costs, audits, property issues, and unresolved termination actions can complicate the process. Contractors should identify applicable requirements and track open items rather than assume that final payment means the administrative work is finished.
Termination for convenience can create uncertainty for both the government and contractors. Its financial consequences depend on the work performed, preparations made, settlement terms, and the governing contract. A useful assessment must look beyond an announcement that performance has ended.
Public figures about terminated contracts should be interpreted carefully. A contract ceiling, an obligated amount, an amount actually spent, and an estimate of avoided future spending measure different things. None should be treated automatically as net savings without considering settlement and other remaining liabilities.
For a contractor, uncertainty about termination can affect staffing, supplier relationships, cash flow, and future business planning. Clear communication between contracts, finance, program management, and leadership helps the business respond promptly and maintain a consistent record of its actions.
For consistent learning across contracts, finance, and program teams, explore FPS Corporate Solutions and its enterprise training options.
What Should Contractors Do After Receiving a Termination Notice?
The contractor's response should be grounded in the notice, the contract, and the applicable regulations. A convenience termination is a contractual action; the settlement process should focus on the rights, responsibilities, and documented costs arising from that action.
What must contractors be prepared to do? Review the relevant provisions of FAR Parts 49, 12, and 4, as applicable. Know the terms and conditions in the contract, identify the regulations and deviations being used, and take the initiative to clarify responsibilities and deadlines with the contracting officer.
Under FAR 49.102(d), the contracting office may reinstate a terminated portion, in whole or in part, with the contractor's written consent. The government must also determine in writing that circumstances clearly indicate a requirement for the terminated items and that reinstatement is advantageous to the government. Reinstatement is an authorized possibility, not a contractor entitlement.
A contractor may need to evaluate both settlement recovery and whether there is a basis to challenge the termination. Those issues are not necessarily mutually exclusive. While evaluating its options, the contractor should comply with the notice, mitigate costs, maintain records, and preserve applicable rights and deadlines.
The government's power to terminate for convenience is broad, but it is not unlimited. Challenges based on bad faith or abuse of discretion depend on the facts and carry substantial hurdles. A disagreement with the government's priorities or business judgment does not, by itself, establish an improper termination.
In Krygoski Construction Co. v. United States, 94 F.3d 1537 (Fed. Cir. 1996), the Federal Circuit upheld the government's termination and emphasized the contracting officer's discretion and the limits imposed by bad faith or clear abuse of discretion. It is therefore too broad to say that termination for convenience can never be used to address procurement problems. Contractors should evaluate the actual decision and applicable precedent rather than rely on a categorical list of prohibited motives.
When the formal termination notice arrives, review whether the action is complete or partial and identify the effective date. Confirm what work must stop, what performance must continue, and what instructions apply to property, subcontracts, and settlement preparation. Direct administrative questions to the contracting officer and keep the answers in the contract record.
When Must a Contractor Submit a Termination Settlement Proposal?
Under the standard noncommercial clauses at FAR 52.249-2(e) and FAR 52.249-6(f), the final settlement proposal generally must be submitted promptly and no later than one year after the effective termination date, subject to the provisions for extensions and late proposals. Separate deadlines apply to other submissions. For example, FAR 52.249-2(l) generally gives 90 days to request an equitable adjustment for the continuing portion after a partial termination. Contractors must check the clause actually incorporated into their contract.
Preparation should begin immediately. Segregate termination costs, notify affected subcontractors and suppliers, coordinate with employees assigned to the work, identify relevant government property, and preserve supporting documentation. Record the steps taken to reduce unnecessary costs. A complete, well-supported proposal is easier to evaluate than one assembled from missing records after the deadline approaches.
Organizations that want training tailored to their own procedures and challenges can explore FPS Custom training.
What Are the Key Takeaways for Federal Contractors?
Know the acquisition rules. Monitor day-to-day occurrences on the project and relevant changes in government policy and the courts. Understand your rights, navigate the administrative procedures, and support your recovery with accurate documentation. Take the initiative. Be proactive.
Where Can Contractors Find the Rules and Supporting Resources?
How Can FPS Help Your Team Prepare?
Build the knowledge your team needs to manage closeout and respond to termination with confidence. Explore FPS training or connect with FPS about whole-team learning across the government contracting lifecycle.
